What Should I Do Before Starting a Kitchen Remodel?

Big choices, like deciding to hire a contractor or doing it yourself, need to be made before starting a project.

Dream and Set Realistic Goals

Do you know how to start a kitchen remodel? Begin by envisioning your end-goal, your dream. Gather photos and design inspiration. Will you replace cabinets, countertops, flooring, and appliances? Add a second sink or upgrade to a decorative range hood? Move a wall? Dream big, and then ask yourself what's a must-have and what's nice-to-have.

Create a Budget

Regardless of the total dollar amount, it’s important to create a budget. Learn what costs to expect and How to set your budget.

Keep your budget flexible by setting aside 10 to 20 percent for unplanned expenses.

Research and Hire a Contractor

If you’re hiring a General Contractor, do your research and set aside time to interview at least three. Start this process early because qualified contractors are often booked 4 to 8 months out.

Read More
Read Less
01
U-shaped kitchen with white shaker cabinets with overlay doors

Step 1: How to Plan Your Kitchen Layout and Design

Planning your kitchen remodel is the foundation for a successful project. It can take anywhere from a few weeks to a few months, depending on when you plan to remodel your kitchen.

Measure Your Space

Taking a few simple measurements of your space is all that’s needed to start a free kitchen design. If you’re working with a contractor, they can help collect detailed measurements.

Order Cabinet Samples

Selecting a cabinet door style and color sets the tone of your kitchen. It also helps you choose countertops, flooring and more. Ordering samples early in the process will give you plenty of time to decide on a favorite.

Talk With a Kitchen Designer

Talking with a kitchen designer will help you translate your ideas and inspiration into a beautiful and functional kitchen. After discussing your wants, needs, and budget, your designer will create an initial kitchen design which you can revise together until it matches your vision and goals.

Apply for Building Permits

A building permit is often required for structural, plumbing, mechanical, and electrical alterations to a house. If you have a contractor, he or she should take care of permitting. This process can take weeks or months depending on the complexity of the project and the municipality, so apply early.

Finalize Your Plans

Finalize your kitchen cabinet design, timeline, plans, and contracts. Create your own scope of work detailing who is responsible for each part of the project. Set a date for when the work should be completed. This will help avoid delays and miscommunication.

Read More
Read Less
02
Shopping for and ordering your products can take several months

How Long Does it Take to Order Kitchen Cabinets and Materials?

Shopping for and ordering your products can take several months.

It's best to wait for all your materials to arrive before demolishing any part of your kitchen.

Order Appliances

As you choose appliances, keep in mind that their sizes affect cabinets. Communicate any appliance changes with your designer before ordering cabinets to confirm they will fit with your final design.

Order Cabinets

After finalizing your kitchen design, you will order the cabinets. The lead time for cabinetry will vary depending on the cabinet manufacturer. See lead times for each cabinet line in CliqStudios.

Order Complementary Products

With your cabinet selection complete, it’s time to shop for complementary products. This includes: flooring, hardware, countertops, lighting, sinks, faucets, and more.

Remember that any special order products may require extra delivery time.

Inspect and Store New Products

Prepare space in a garage or other dry area where you can inspect and store each new product. Many products, like wood cabinets and flooring, will need to be stored in a climate-controlled area.

Establish a Temporary Kitchen

Before demolishing your current space, establish a temporary kitchen. For some, this may be as simple as a dorm-sized refrigerator and microwave. For others, an outdoor grill is the perfect solution.

You may want to budget extra time and money for eating out more frequently during the rest of the project.

Pack up Your Kitchen

Before the sledgehammers start swinging, you’ll need to pack up everything in your kitchen. If you haven’t already, this would be a good time to declutter your kitchen.

Be sure to leave out items you will need in your temporary kitchen.

Read More
Read Less
03

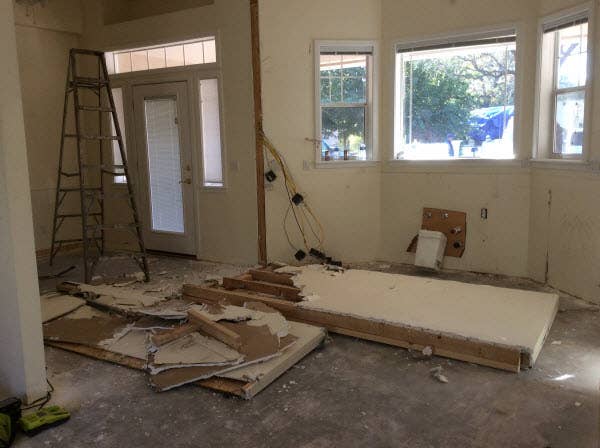

a room with a lot of pieces of concrete on the floor and a ladder.

What is Involved in the Kitchen Rough Construction Phase?

Rough construction means demolishing the existing kitchen, building out structural features, and framing the room. If you are keeping the same room footprint and appliance placement, this step could be completed in one week or less.

Demolish Your Kitchen (1 week)

After all new materials arrive and have been inspected, it is time to demolish your current kitchen. If you’re handling the demo yourself, have a plan for how to dispose of waste.

Before you begin demo, confirm that the gas, water, and electric are off in the area you're working in.

Make Structural Changes (2-4 weeks)

Make structural changes like new windows, walls, or doorways. DIYers should consult a professional to ensure that any structural changes, like removing walls, are done safely.

Countertops cannot be fabricated before cabinets are installed. Be sure to schedule the measurements for after cabinets will be installed.

Rough-in Plumbing, Mechanical, and Electrical (3-5 days)

Most utility rough-in work needs to be completed before the drywall and flooring is installed. This gives access to the wiring for inspection and placing outlets, fixture boxes, and switches.

Utilities will need to be approved by a local building inspector before moving on to the next step. This will most likely take one week.

Install Drywall and Paint (1 week)

Hang and finish new drywall and insulation, if needed. Prep, prime, and paint any surfaces that can be completed before installing flooring.

Install Flooring (2-3 days)

Many types of flooring, like tile and hardwood, should be installed before cabinetry. Some floating floor types, like luxury vinyl flooring and laminates, must be installed after the cabinets.

Read More
Read Less
04
Finish Construction

Final Steps: How Long Does Finishing a Kitchen Renovation Take?

Finish construction is when all new products are installed in the kitchen. This is the final, and perhaps most satisfying, phase of the kitchen remodeling process.

Install Cabinets (3-5 days)

It is time to install the largest part of the kitchen, new cabinets. DIYers can watch our cabinet installation videos for reference.

Measure, Fabricate, and Install Countertops (2-4 weeks)

Only after cabinets are installed can measurements for countertops be taken. Fabrication, or making the countertop, can then take place. This can take up to one month depending on the material. The final step is installation.

Install Appliances and Fixtures (1-5 days)

Lighting is installed after countertops are added. Appliances and plumbing fixtures can also be installed at this time. Use caution moving heavy appliances so they do not ding or scratch new flooring and cabinets.

Finishing Details and Hardware (1-2 weeks)

The finishing touches of the kitchen include cabinet hardware, crown molding, paint touch-ups, and any other details. Level all appliances and check their connections.

Install Backsplash (2-3 days)

Backsplash is the last major item to be installed. It usually takes two days, but could take longer if you’re creating a detailed design.

If a building permit was required, schedule a final inspection by a building inspector. These take place during business hours.

Clean the Construction Zone (1-2 days)

Cleaning includes: clearing the room and ventilation system of dust and debris, wiping down cabinets, and scheduling haul-away of any garbage dumpsters.

Read More
Read Less
05
Finish Construction

Project Completion: What Happens After a Kitchen Remodel is Done?

Congratulations, your kitchen is brand-new and fully functional! Unpack your items and find a new home for each one. You’re ready to show off your new kitchen!

In addition to the kitchen remodeling timeline, designing a kitchen can be complex. Starting with overall design, it’s important to first identify what you want in your new space. Do you need more storage? Are you lacking in counter space? Are there any major shortcomings in your existing layout? Focus on these issues first, then moving on to the next step will be easier.

The next best step is to identify your interior design style. If this doesn’t come naturally to you, explore Pinterest, or talk to a professional CliqStudios designer. Sometimes it’s best to do both. During your conversation with a designer, tell them about the materials you like and what tends to draw your attention. You can even share your favorite pins with them. Once your designer has a solid idea of your tastes, it’s much easier to design your custom kitchen.

Take advantage of CliqStudios’ free kitchen design services. Doing this will easily save you thousands of dollars compared to studio fees, and we offer hundreds of cabinets options in every style and budget. Our designers provide personalized attention and custom designs every time. During this process, your designer will ask you about your storage preferences and dreams for the kitchen. This means you no longer have to worry about all the details. Once appliances are chosen and the kitchen cabinets ship, you're on the way to scheduling installation and countertops.

Ready to start your free design?

Take the first step toward your dream kitchen today! We’ll connect you with your personal designer to make your project a reality.

Let’s Get Started

Frequently Asked Questions

How long does a kitchen remodel take?

A typical kitchen remodel takes 6 to 9 months from the first design consultation to the final walkthrough. While the active construction phase usually lasts 8 to 12 weeks, the preceding months are dedicated to planning, permitting, and ordering custom materials like cabinetry.

What is the typical timeline for a kitchen remodel?

The standard timeline is divided into four main stages:

  • Planning & Design: 1–3 months
  • Ordering & Logistics: 1–2 months
  • Demolition & Rough Construction: 2–4 weeks
  • Finishing & Installation: 4–8 weeks

How much does a kitchen remodel cost?

On average, a kitchen remodel costs between $25,000 and $65,000. Minor updates may start as low as $15,000, while high-end luxury renovations involving structural changes and professional-grade appliances can exceed $100,000.

What is the most expensive part of a kitchen remodel?

Cabinetry is typically the most expensive part of a kitchen remodel, often accounting for 25% to 35% of the total budget. Following cabinets, labor and installation costs represent the next largest expense, followed by appliances and countertops.

What should I consider when planning a kitchen remodel?

When planning, you must prioritize functionality (the work triangle), budget, and storage needs. Additionally, consider how long you plan to stay in the home, as this dictates whether you should design for personal taste or for maximum resale value.

How much should a 10x10 kitchen remodel cost?

A standard 10x10 kitchen remodel typically costs between $15,000 and $30,000. This "benchmark" size is used by designers to provide baseline estimates for mid-range cabinetry, countertops, and basic appliance upgrades without major structural shifts.

Is a kitchen remodel worth it?

Yes, a kitchen remodel is widely considered one of the best home investments. Homeowners typically see a Return on Investment (ROI) of 50% to 80%, and a modern, functional kitchen is often the primary selling point that decreases a home's time on the market.

Can you replace kitchen cabinets without replacing countertops?

Technically, yes, but it is not recommended. Because countertops are usually templated and glued directly to the cabinet frames, removing the cabinets without breaking the stone or laminate is extremely difficult and often costs more in labor than simply replacing both.
